Compressing an Expedited Custom Piping Lifecycle to 7 Days

July 9, 2026 by
Compressing an Expedited Custom Piping Lifecycle to 7 Days
Prodsource Solutions, LLC, Colin Mattox

Executive Summary

In critical heavy-industrial operations, unexpected project delays or fixed vendor backlogs do not just disrupt timelines, they introduce massive capital risk. When a client recently faced a critical bottleneck requiring oversized pipe spools fabricated on an expedited 7-day timeline, traditional single-facility manufacturing options quoted non-viable lead times of 4 to 6 weeks.

By leveraging an elastic, distributed network structure, ProdSource Solutions bypassed the constraints of fixed-capacity facilities. We isolated and parallel-processed the project lifecycle phases, delivering fully compliant, structural-grade oversized spools within the requested 7-day window with zero deviations from strict engineering standards.

The Challenge: Bypassing Fixed-Facility Backlogs

Traditional manufacturing relies on linear scheduling within a single facility. If a shop's welding bays are full or its raw material supply chain experiences a minor disruption, the entire project timeline cascades outward.

For this project, the client required heavy-wall, oversized pipe spools with complex geometries. The technical constraints were unforgiving:

  • Full adherence to structural engineering and pressure-piping codes.

  • Strict non-destructive testing (NDT) and weld-integrity verification.

  • A hard delivery deadline exactly 168 hours from order placement.

To meet this timeline, a linear processing model was mathematically impossible. The solution required an architectural shift in manufacturing logistics: parallel production.

Phase 1: Accelerated Supply Chain Aggregation

Before a single torch could be lit, raw materials had to be secured, verified, and routed. Traditional material procurement through standard distribution channels routinely consumes 7 to 10 business days for non-standard, large-diameter piping components.

Using a decentralized sourcing model, our procurement teams tapped into an agile network of regional material suppliers. By cross-referencing real-time inventory data across multiple unbottlenecked hubs, we successfully completed material aggregation, Mill Test Report (MTR) verification, and logistics routing within a strict 96-hour window.

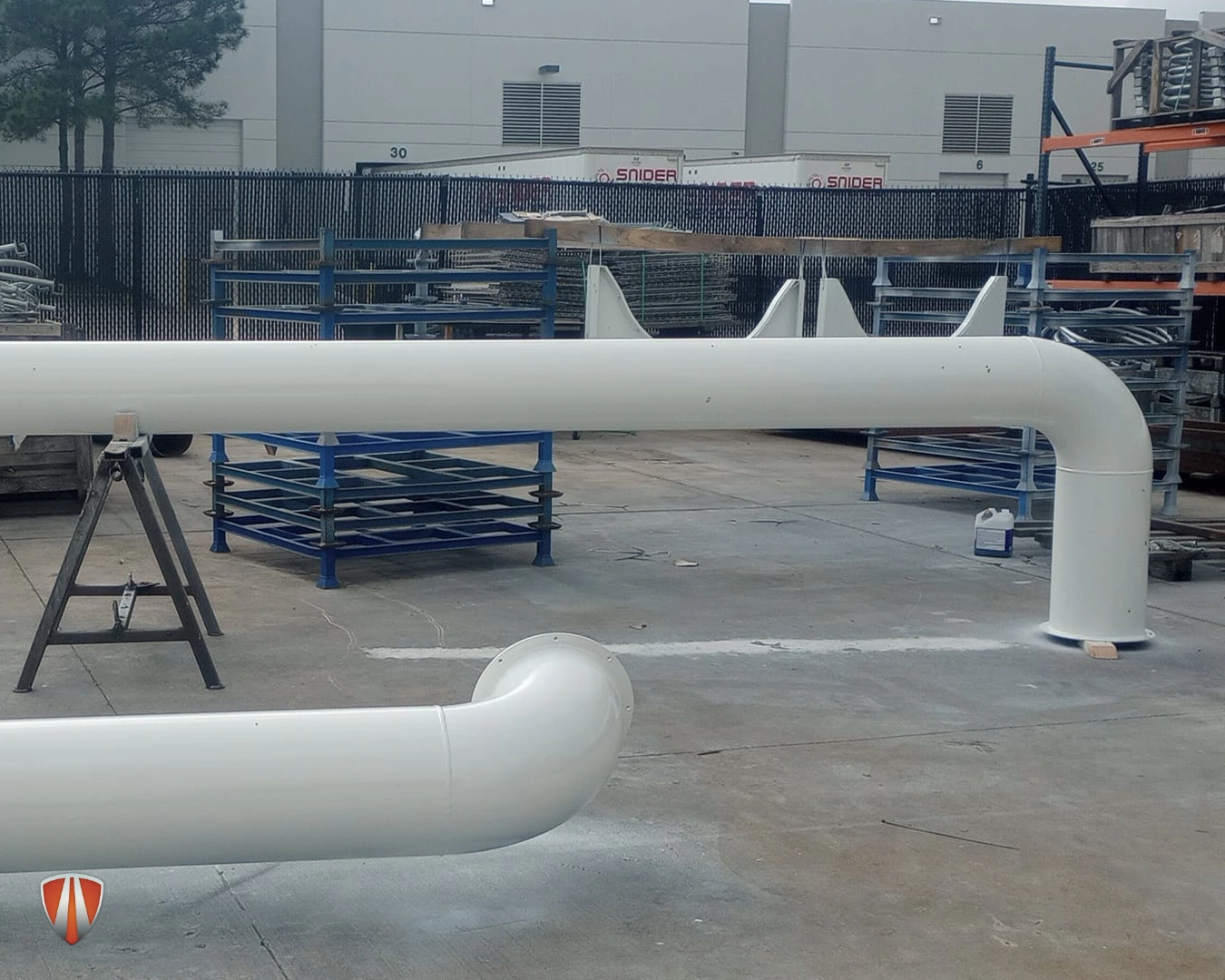

Initial stage tracking of oversized piping components during accelerated regional sourcing and material staging.

Phase 2: Decentralized & Parallel Production Scaling

The core driver of the 7-day turnaround was our ability to segment the fabrication blueprint. Rather than routing the spools through a singular production line, the project's sub-assemblies were isolated and parallel-processed across highly specialized partner facilities.

During a synchronized weekend cycle, production was scaled concurrently:

  • Facility A executed high-precision automated cutting, beveling, and end-preparation.

  • Facility B mobilized dedicated teams of certified code-welders to handle complex flange attachments and heavy-wall structural joints simultaneously.

This distributed methodology effectively multiplied available man-hours without incurring the overhead or spatial bottlenecks of a single crowded shop floor.

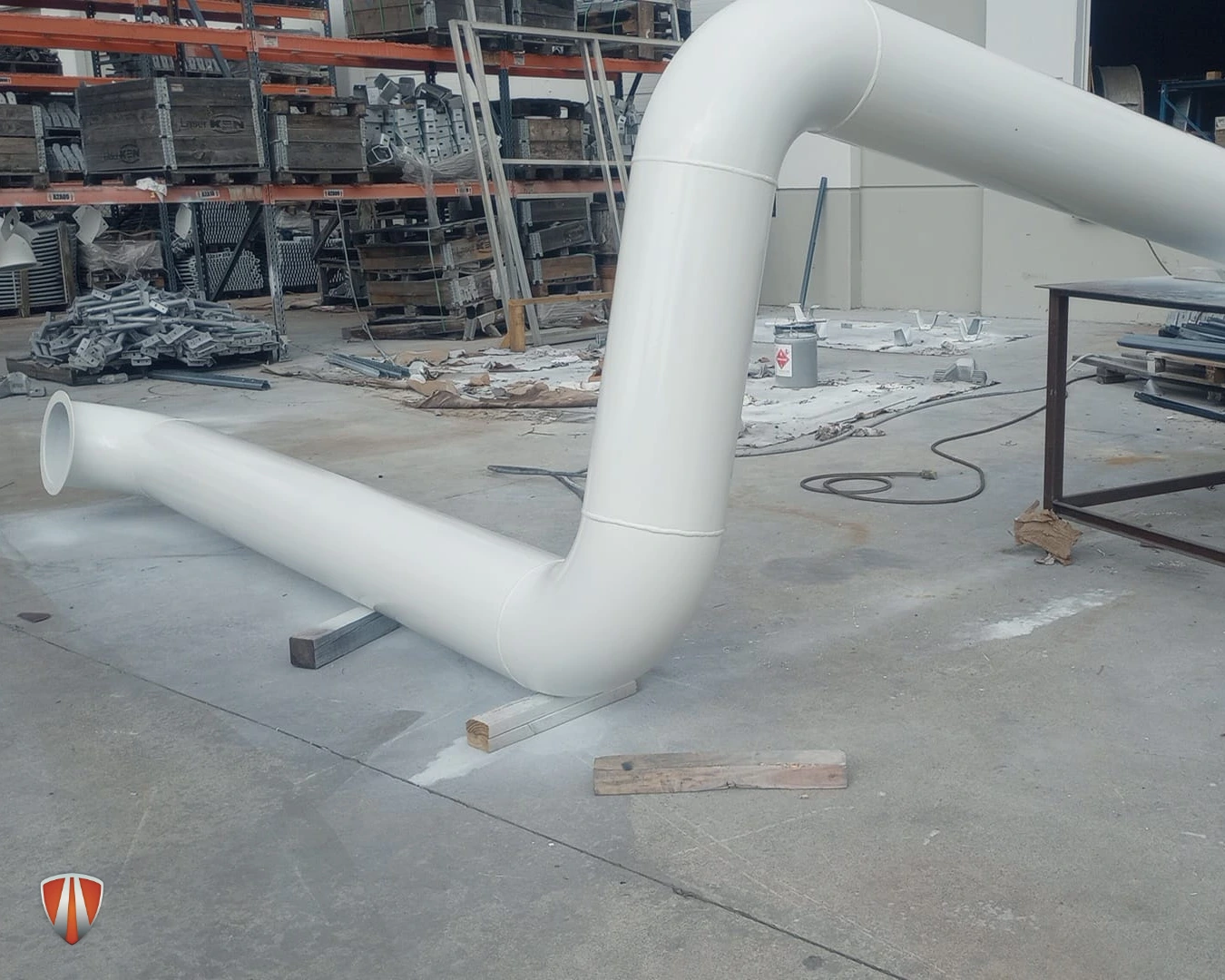

Parallel fabrication and specialized code-welding executed concurrently across unbottlenecked network facilities over a compressed weekend cycle.

Phase 3: Quality Insulation & Rigorous Testing Compliance

In high-pressure industrial applications, speed means nothing if it compromises structural integrity. Accelerated timelines frequently fall apart during the Quality Assurance (QA) phase, as testing queues become an afterthought.

To insulate quality from the expedited timeline, a strategic 24-hour shipping hold was natively integrated into the final phase of the lifecycle. Once assembly was completed, independent certified inspectors conducted comprehensive quality compliance checks directly at the closing facility:

  • Visual Inspection (VT): Complete geometric and dimensional verification against original engineering schematics.

  • Non-Destructive Testing (NDT): Rigorous weld integrity validation to ensure total penetration and zero volumetric defects.

  • Coating and Insulation Protection: Application of high-durability industrial coatings designed to withstand aggressive operational environments.

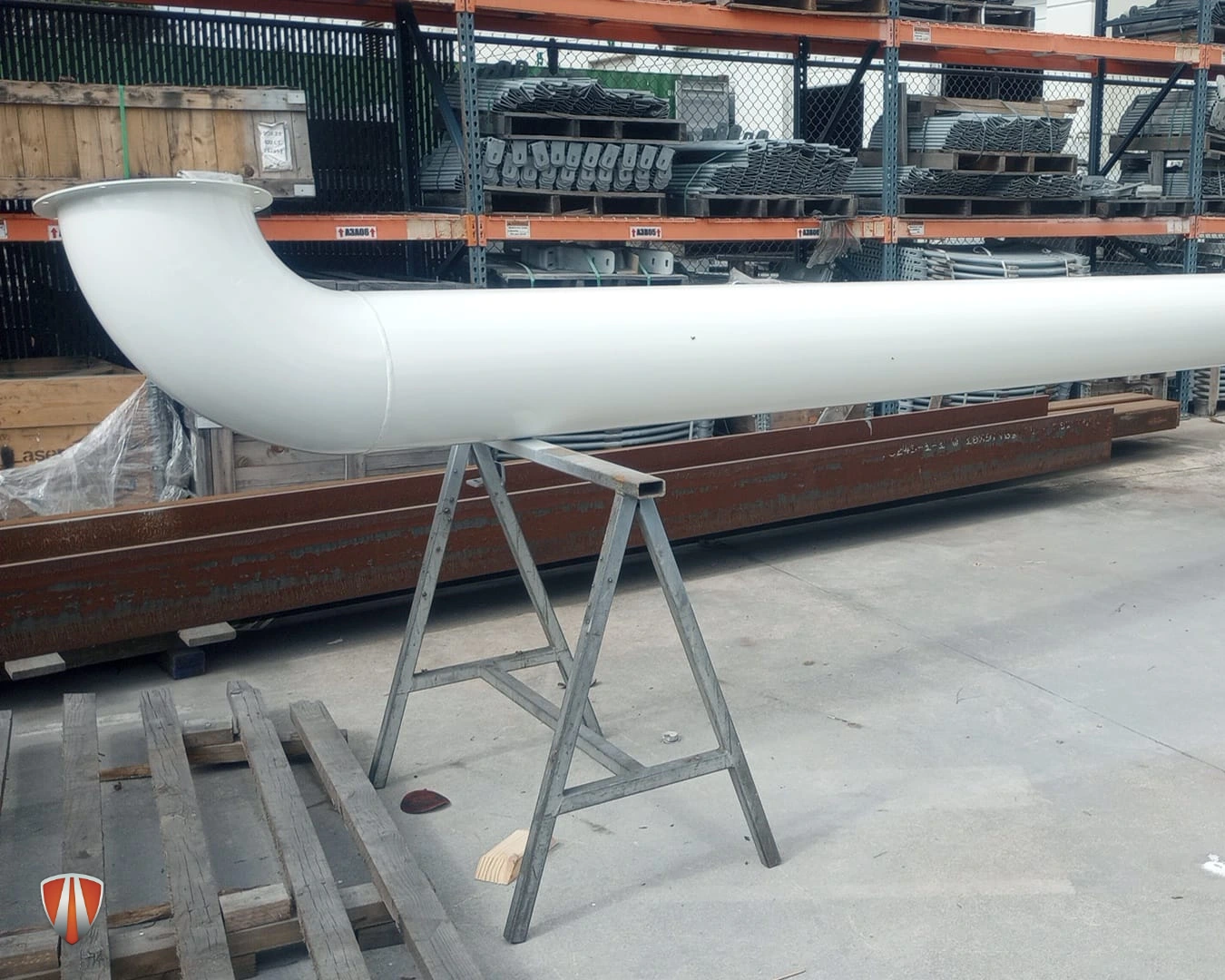

Completed assembly undergoing final NDT weld-integrity validation and structural QA certification prior to secure transport.

The Result: Quantifiable Schedule Protection

The completed, certified oversized spools were successfully transferred to the client on Tuesday. While navigating an extreme 7-day expedited window pushed the final handover slightly past the initial best-case target date, the total project lifecycle was still compressed by over 70% compared to traditional market averages.

More importantly, by delivering weeks ahead of a standard vendor's timeline, the client successfully avoided an extended operational standstill, proving that critical infrastructure schedules can be protected when manufacturing capacity is elastic.

Optimize Your Project Lifecycle

Don't let fixed vendor backlogs dictate your construction or operational timelines. Discover how ProdSource Solutions can deploy elastic network capacity to protect your critical path schedules.

Contact our procurement and engineering team today.


Deploying Elastic Capacity to Fabricate 120 Structural I-Beam Bases in 12 Weeks
